Morena Conveyance South & Middle and Morena Conveyance Bike Lanes
The Morena Conveyance South & Middle and Morena Conveyance Bike Lanes project will connect the Morena Pump Station at Sherman and Custer Streets in Bay Park with the Morena Pipelines Northern Alignment in University City.
This project includes the installation of 48-inch wastewater forcemain pipeline (approx. 36,170 LF) and 30-inch welded steel pipe brine centrate/conveyance pipeline (approx. 36,170 LF) and associated appurtenances.

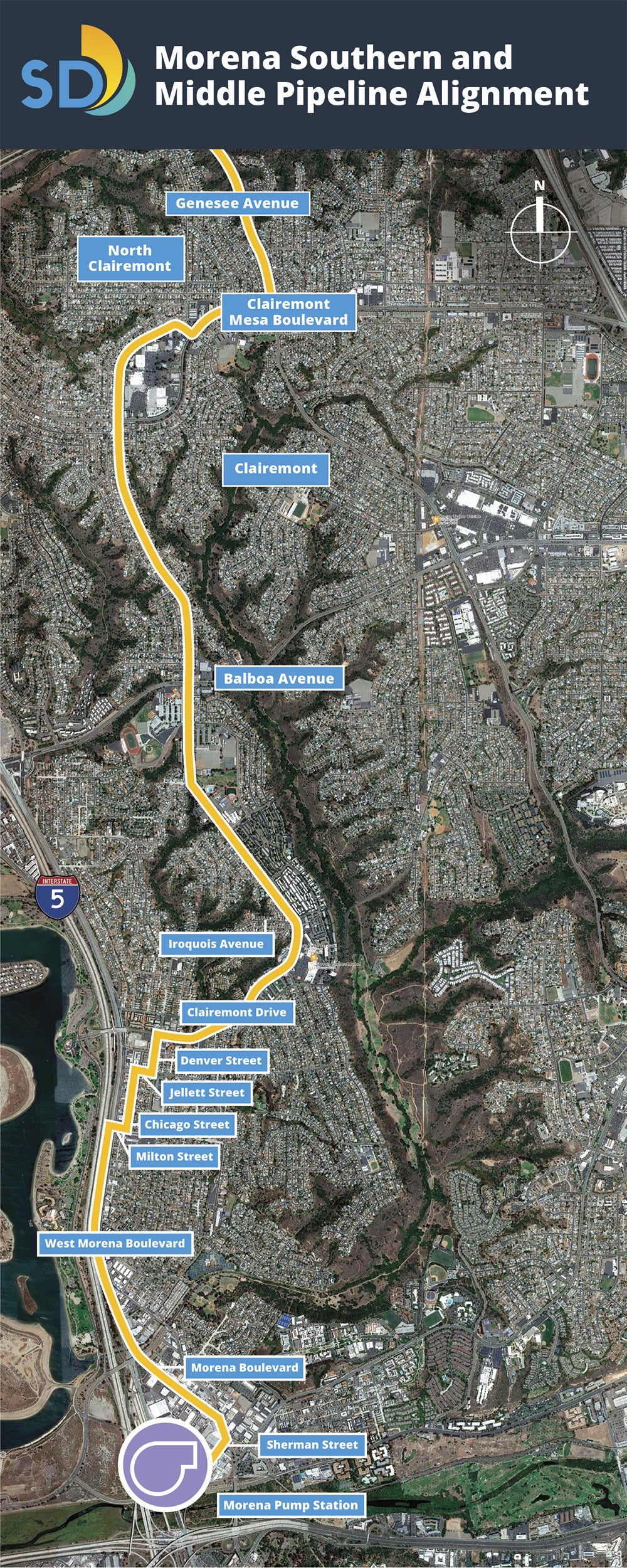

The Morena Pipelines Southern Alignment begins at the Morena Pump Station at Sherman Street and Custer Street and continues north on Morena Boulevard, Milton Street, Chicago Street, Jellett Street and Denver Street to Clairemont Drive.
The Morena Pipelines Middle Alignment begins on Clairemont Drive near Iroquois Avenue and continues north through Bay Ho to Clairemont Mesa Boulevard (north of Clairemont Town Square), Genesee Avenue and ends near Appleton Street.
Bike Ways
This project will install improved bikeways along impacted roads within the project limits:
- Genesee Ave.
- Clairemont Mesa Blvd.
- Clairemont Dr.
- Morena Blvd.
- W. Morena Blvd.
Construction Schedule
Anticipated Start: October 2022
Anticipated Completion: 2025
This project will require both nighttime and daytime construction at various stages. Stakeholders will be notified of any anticipated changes in the work schedule 7 days in advance via door hanger.
Nighttime construction is expected to take place on weekdays from 4:30 p.m. to 11:30 p.m.
Daytime construction is expected to take place on weekdays from 7:30 a.m. to 4:30 p.m.
Informational Materials
Construction Notices
- December 4, 2024 - Project Wide Update and Looking Ahead to 2025
- November 8, 2024 - Next Phase of Traffic Control on Clairemont Drive
- October 29, 2024 - Bay Park: Upcoming Pure Water Work in Your Neighborhood
- October 25, 2024 - Upcoming Night Work and Water Shutdowns on Clairemont Drive
- October 8, 2024 - Project Wide Progress and Paving Update
- October 3, 2024 - Upcoming Work Between Erie Street and Galveston Street
- September 25, 2024 - Next Phase of Traffic Control on West Morena Boulevard
- September 11, 2024 - Next Phase of Work on Clairemont Drive
- September 5, 2024 - Upcoming Work at Morena Boulevard and Napa Street
- August 28, 2024 - Upcoming Traffic Control on West Morena Boulevard
- August 2, 2024 - Next Phase of Traffic Control on Clairemont Drive
- July 26, 2024 - Schedule Update For Work at Clairemont Drive and Balboa Avenue
- July 23, 2024 - Tonight: Next Phase of Traffic Control on West Morena Boulevard
- June 26, 2024 - Night Work at Clairemont Drive and Balboa Avenue Upcoming
- June 10, 2024 - Clairemont Dr. and Burgener Blvd. Work Update
- June 4, 2024 - Ute Dr. and Clairemont Dr. Work Upcoming
- May 23, 2024 - 5-Day Door Hanger: Upcoming Night Work at Clairemont Drive and Balboa Avenue
- May 23, 2024 - Upcoming Night Work at Clairemont Drive and Balboa Avenue
- May 15, 2024 - Repairs Completed at Morena Boulevard and Sherman Street
- May 14, 2024 - Utility Repairs Underway at Morena Boulevard and Sherman Street
- April 22, 2024 - Upcoming Work Near Schools on Clairemont Drive
- April 12, 2024 - Upcoming Work at Morena Boulevard and Sherman Street
- April 9, 2024 - Morena Conveyance South & Middle Project-wide Update
- March 12, 2024 - Updated Construction Plan for Morena Boulevard and Sherman Street Intersection
- March 12, 2024 - Upcoming Night Work on Clairemont Drive
- February 29, 2024 - Reminder: Work at Morena Boulevard and Sherman Street Starts Tonight
- February 28, 2024 - Night Work to Move Traffic Control Tonight
- February 22, 2024 - Upcoming Work: Morena Boulevard and Sherman Street Intersection
- January 19, 2024 - Upcoming Work: Dakota Drive Intersection and Work Moving North
- January 5, 2024 - Upcoming Work Schedule on Clairemont Drive
- December 19, 2023 - No Work on Clairemont Dr. Due to Forecasted Rain
- December 5, 2023 - Upcoming Work: Iroquois Avenue and Clairemont Drive Intersection
- November 9, 2023 - Upcoming Work: Dakota Drive Intersection and Work Moving South
- October 5, 2023 - Upcoming Traffic Control on Clairemont Drive
- September 19, 2023 - New Traffic Control on Clairemont Drive
- September 15, 2023 - Construction notice: Street Paving on Clairemont Drive
- September 15, 2023 - Street paving on Clairemont Drive
- September 13, 2023 - Work Canceled: Street Paving on Clairemont Drive
- September 12, 2023 - Street Paving on Clairemont Drive
- August 31, 2023 - Upcoming Night Work on Sherman Street
- August 29, 2023 - Construction Notice: Upcoming Construction On Sherman Street
- August 16, 2023 - Additional Traffic Control Setup and Upcoming Work Near Clairemont Village Shopping Center
- August 2, 2023 - Construction Notice: Upcoming Construction On Clairemont Drive Near Clairemont Village Shopping Center
- August 2, 2023 - Looking Ahead: Additional Traffic Control; Upcoming Work Near Clairemont Village Shopping Center
- June 22, 2023 - Starting Tonight: Traffic Control Setup on Clairemont Drive Between Erie St. and Fairfield St.
- June 15, 2023 - 5- Day Door Hanger: Traffic Control Moving East on Clairemont Drive
- June 14, 2023 - Looking Ahead: Work Progressing East On Clairemont Drive, Additional Traffic Control Will Be Set Up
- May 31, 2023 - Traffic Control Setup Beginning on Clairemont Drive, Pipeline Installation to Follow
- May 11, 2023 - Looking Ahead: Traffic Control Setup and Pipeline Installation to Begin in
Clairemont in Late May - April 13, 2023 - Upcoming Water Shutdown at Morena Blvd. and Napa St.
- Feb. 28, 2023 - Night Work Cancelled This Week
- Feb. 23, 2023 - Night Work on Clairemont Dr. and Sherman St.
- Feb. 22, 2023 - 5-Day Door Hanger: Night Work on Clairemont Dr. and Sherman St.
- Jan. 19, 2023 - Night Work on Sherman St. and Clairemont Dr.
- Jan. 18, 2023 - 5-Day Door Hanger: Night Work on Clairemont Dr.
- Jan. 18, 2023 - 5-Day Door Hanger: Night Work on Sherman St.
- Dec. 23, 2022 - Underground Utility Location Work Continues at Several Locations
- Nov. 17, 2022 - 5-Day Door Hanger: Laydown Yard on Balboa Ave.
- Nov. 14, 2022 - Initial Underground Utility Location Work to Begin the Week of Nov. 14 on Clairemont Drive
- Nov. 3, 2022 - 5-Day Door Hanger: Potholing beginning
Community Presentations
- November 19, 2024 - Clairemont Mesa Planning Group Presentation
- September 17, 2024 - Clairemont Mesa Planning Group Presentation
- April 16, 2024 - Clairemont Mesa Planning Group Presentation
- March 7, 2024 - Clairemont Town Council Presentation
- February 26, 2024 - Linda Vista Planning Group Presentation
- October 5, 2023 - Clairemont Town Council Presentation
- July 18, 2023 - Clairemont Community Planning Group Presentation
- April 6, 2023 - Clairemont Town Council Presentation
